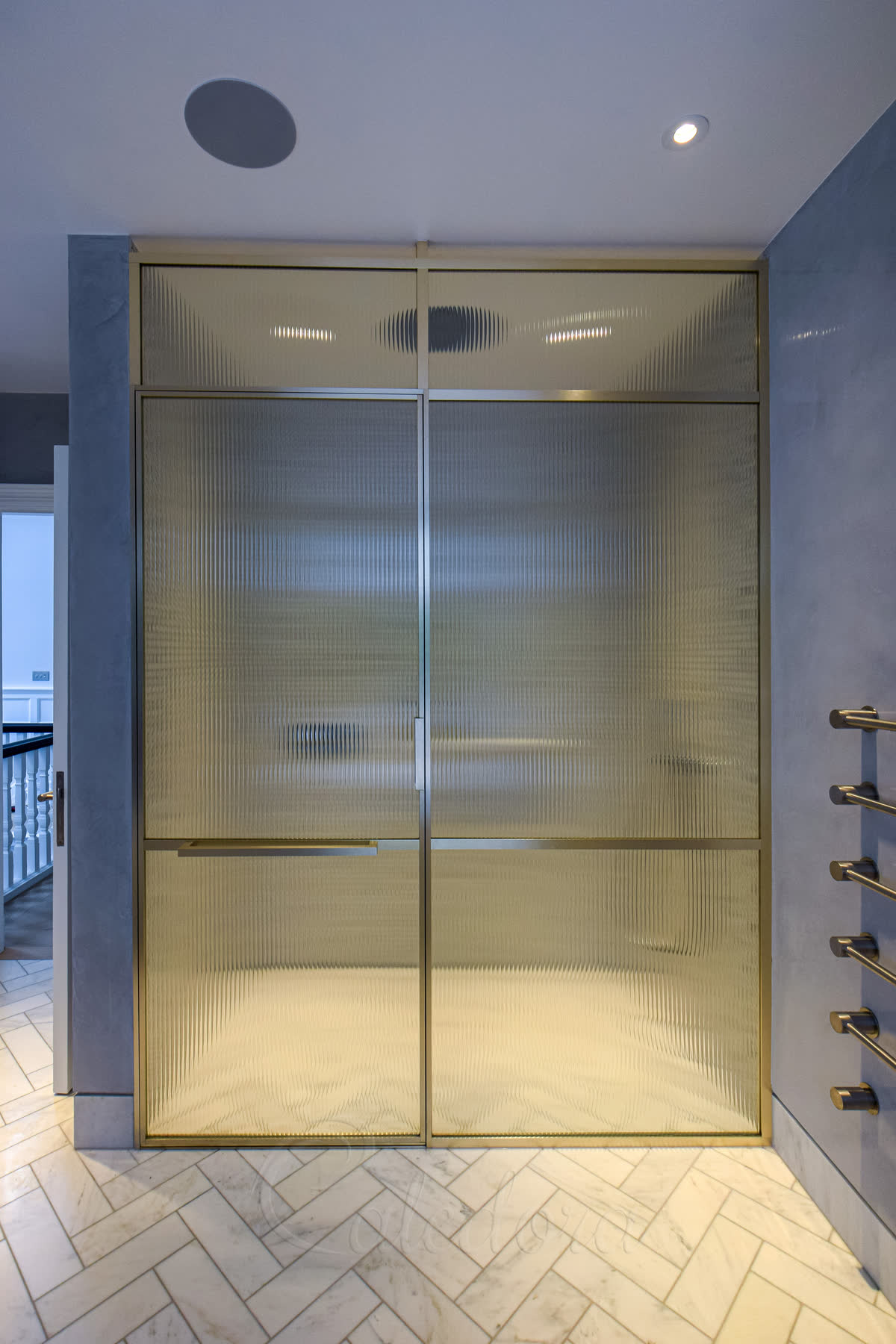

Framed brass shower enclosure with reeded glass and level floor access

Framed Brass Enclosure with Seamless Floor Access

The shower's elegant brass frame houses vertical fluted glass that provides privacy while allowing light to filter through. The level floor creates a continuous flow between the bathroom and shower area, with identical natural stone tiling extending throughout the space.

For more elegant shower solutions like this, explore our level access shower enclosures collection.

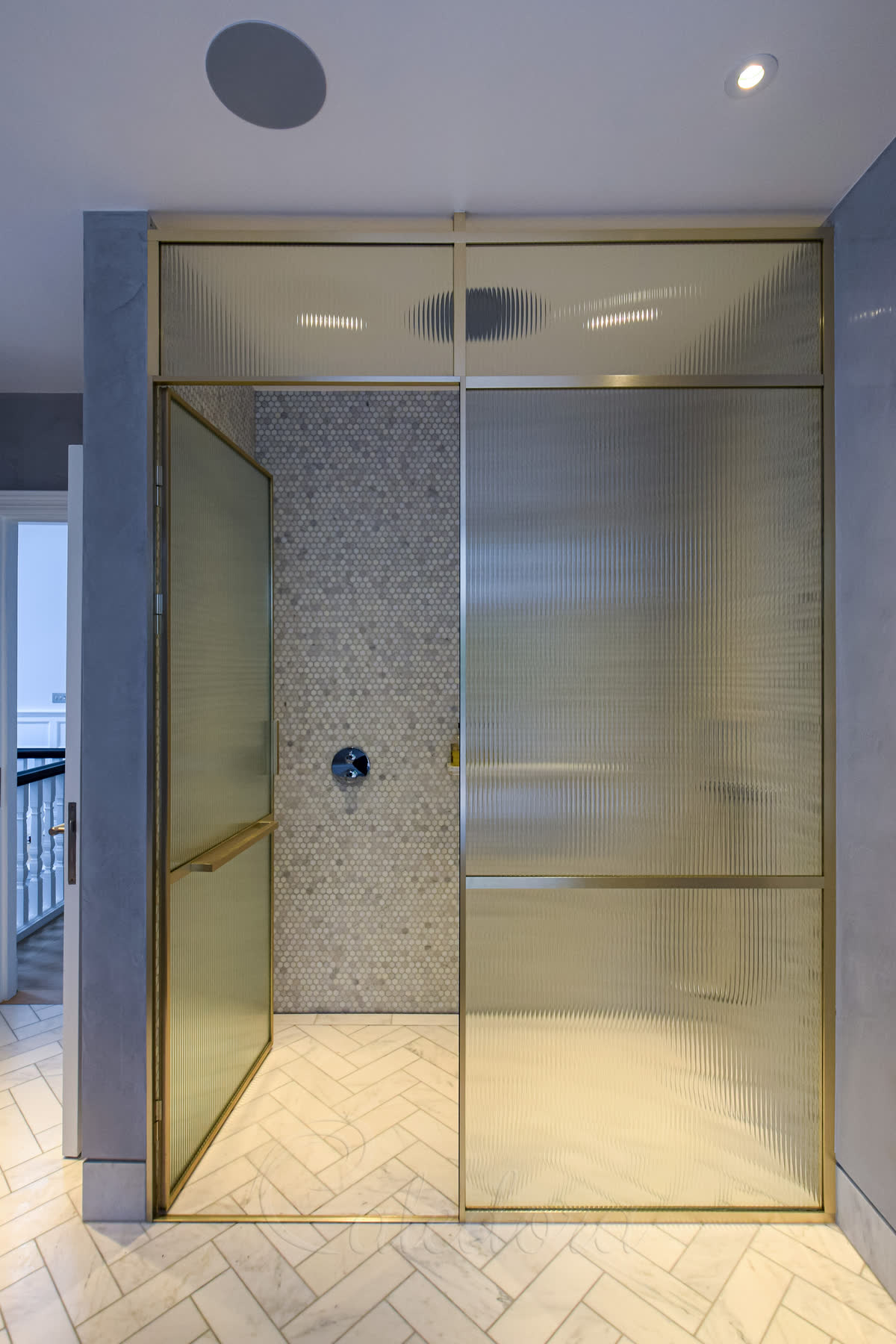

Open brass framed shower door showing mosaic tiled interior and level floor access

Custom Brass Detailing and Practical Features

The inward-opening door features an L-shaped handle on both sides and a custom towel rail on the outer face. A discreet 7mm brass threshold strip along the door line provides water containment without interrupting the level access design.

Our shower solutions can be tailored to any space requirements while maintaining accessibility and style.

Product Specification

Style

Inline Shower Door

Metal Finish

Anodised Bright Gold

Glass Type

Fluted Glass

Frame Style

Fully Framed

Special Features

Customised towel rail, Bespoke Anodising

Price Range

££££

Product Dimensions

Width

1500mm

Height

2500mm

Custom sizes available - contact us for bespoke measurements

Level Access Shower Enclosure Delivery Timeline

Fluted glass requires specialized processing and handling during production. Your Level Access Shower Enclosure timeline includes additional time for textured glass manufacturing.

📋 Multiple Items: Each additional shower enclosure may extend Design, Assembly, and Installation by approximately 1 working day. However, orders of 5+ units benefit from streamlined production processes that reduce per-unit time. We'll provide an optimized timeline for your specific project.

Tiling Ready

Faster Option

Your walls are tiled and ready for fluted glass installation. We'll take precise measurements and begin the specialized textured glass production process.

Site Survey 1 day
Precise measurements and photos
Design & 3D 3 days
Create and approve your custom design
Parallel Production 20 days
Frame (20d) and Glass (8d) made simultaneously
Assembly 3 days
Glass fitted into frames
Installation 2 days
Professional on-site installation

✓ Efficient Process: With tiling complete, we take all measurements in one visit and run frame and glass production simultaneously.

29
Working Days Total
25
Production Days
2
Days On-Site

Timeline Considerations for This Project

  • The bespoke CNC-cut towel rail must be completed first before we can begin the anodising process, extending production time.
  • All parts require anodising in bespoke light gold finish, which adds extra time compared to standard finishes. Black finish is available for faster delivery.

Tiling Not Ready

Extended Timeline

Your walls need tiling before fluted glass installation. We'll take rough measurements for design visualization, prepare for specialized glass production, then finalize measurements after tiling.

Initial Visit 1 day
Rough measurements and photos
Design & 3D 3 days
Create initial design based on rough measurements
Frame Production 20 days
Can start while tiling is in progress
Waiting for Tiling Variable
Depends on your tiling schedule
Final Measurements 1 day
Precise measurements once tiling is complete
Design Adjustments 1 day
Update design if dimensions changed
Glass Production 8 days
Cut to exact measurements
Assembly 3 days
Glass fitted into frames
Installation 2 days
Professional on-site installation

💡 Flexible Timeline: The waiting period begins after frame production (day 24) and varies based on your tiling schedule. If your tiling is completed during our frame production period, we can arrange the final measurements earlier and advance the entire schedule - moving final measurements, design adjustments, glass production, assembly, and installation to start as early as day 5 (right after design confirmation). The total timeline shows the minimum 41 working days if tiling is ready when frames are done.

41
Working Days Minimum
17
Production Days
2
Days On-Site

Interested in a Similar Design?

Let our experts create a bespoke shower solution perfectly tailored to your space. From survey to installation, we handle everything with precision and care.

Contact Us

Understanding Our Pricing

Each symbol reflects a full-service estimate, including survey, design, production, and installation. We only offer complete packages — no supply-only options.

Prices are adjusted based on real projects and assume the installation is within one hour's travel from one of our offices. Travel beyond this range may increase the price.

VAT is not included and will be added where required. Displayed prices are for guidance only and reflect localised, complete installations.

Price Range Guide

  • £ Up to £1,500
  • ££ £1,501 - £2,500
  • £££ £2,501 - £3,200
  • ££££ £3,201 - £8,000
  • £££££ £8,001+
